Quick answer: Building plan approval in Jabalpur in 2026 goes through Madhya Pradesh's ABPAS (Automated Building Plan Approval System) portal at mptownplan.gov.in — JDA Jabalpur for planned and peri-urban areas, JMC Jabalpur for core city wards. Timeline is 30–60 days when submitted correctly. Total fees for a 1,000–1,500 sq ft residential home: ₹40,000–₹90,000. Jabalpur has one significant approval complexity most guides miss — plots near the Military Cantonment area require a separate Defence NOC, adding 30–45 days to any timeline.
Jabalpur is growing rapidly — new residential colonies are developing across Tilhari, Gorakhpur, Adhartal, and the NH44 corridor, while established areas like Civil Lines, Napier Town, and Vijay Nagar continue to see renovation and expansion. With residential construction costs running at ₹1,800–₹2,400 per sq ft in 2026, getting the approval process right protects your entire investment.
This guide walks through exactly what building plan approval in Jabalpur involves, who the approving authority is for your specific plot, what it costs, and where most applications go wrong.
→ Find JDA-experienced, COA-registered architects in Jabalpur on BidandBuild — free consultation, zero commission
Step 1: Confirm Your Approval Authority
Jabalpur has two separate approving authorities — and the Cantonment Board adds a third layer for specific zones. Submitting to the wrong one means rejection and restarting from zero.
| Authority | Areas Covered | Portal | Timeline |
|---|---|---|---|
| JDA Jabalpur | Planned sectors, JDA schemes, peri-urban — Tilhari, Gorakhpur, Adhartal, Vijay Nagar, NH44 corridor, Marhatal | ABPAS at mptownplan.gov.in | 30–45 days |
| JMC Jabalpur (Nagar Nigam) | Core city wards — Civil Lines, Napier Town, Sadar, Gokul Das, Omti, Gwarighat | ABPAS at mptownplan.gov.in | 20–40 days |
| Cantonment Board Jabalpur | Military Cantonment zone — Sadar Bazar, Lines area, Defence colony adjoinments | Separate Defence portal + NOC | 60–90 days |
JDA Jabalpur is located at Block No. 7A, JDA Building, Marhatal, Jabalpur. Contact: 0761-2402832, Email: ceojda@gmail.com. JMC is at nagarnigamjabalpur.com.
Your plot's registry document or allotment letter will indicate jurisdiction. When in doubt, visit the JDA office at Marhatal or call the JDA helpdesk before approaching any architect.
For construction cost context alongside this approval guide, see House Construction Cost in Bhopal 2026 — rates for Madhya Pradesh Tier-2 cities are broadly similar to Jabalpur.
Three Jabalpur-Specific Facts Nobody Tells You
These are not in most building approval guides. Each one directly affects your timeline and budget.
Fact 1: The Cantonment NOC — The Most Missed Requirement in Jabalpur
Jabalpur is home to one of India's oldest and largest military cantonment areas — covering Sadar Bazar, the Lines area, and several Defence-adjacent residential colonies. Plots within or adjoining the Cantonment boundary require a No Objection Certificate from the Cantonment Board before JDA or JMC will process your application.
This NOC adds 30–45 days and involves a separate application to the Cantonment Board administration. Many homeowners discover this requirement only after submitting their ABPAS application and receiving a query — by which point weeks have already been lost. Ask your architect to confirm Cantonment proximity status from your plot's registry document at the very first meeting.
Fact 2: Basalt Rock Soil in Bhedaghat-Adjacent Areas
Jabalpur's famous Marble Rocks at Bhedaghat sit on basalt rock formations that extend into several fringe areas of the city — including parts of Lamheta Ghat, some areas of Tilhari, and the Narmada-adjacent western zones. Unlike Bhopal's black cotton soil problem, basalt presents the opposite challenge: extremely hard rock that increases excavation costs significantly — sometimes ₹1.5–₹3 lakh more than a standard foundation on normal soil for a 1,000 sq ft home.
An architect or contractor familiar with Jabalpur's geology will know which zones are basalt-prone and can advise on mechanical excavation rather than manual digging. Get a geological surface assessment for your specific plot before finalising your foundation design, especially in western Jabalpur near the Narmada.
Fact 3: Narmada Flood Zone — MOEF NOC for Riverside Plots
Plots in close proximity to the Narmada river — Gwarighat area, Lamheta, and parts of Tilhari on the river side — may require MOEF (Ministry of Environment and Forests) environmental clearance for construction. This adds 30–45 days. Check the flood zone status of your plot at the Jabalpur Collectorate before purchasing or designing for any riverside location.
How the ABPAS Portal Works in Jabalpur
ABPAS (Automated Building Plan Approval System) is Madhya Pradesh's statewide online building plan portal at mptownplan.gov.in. All JDA and JMC Jabalpur applications are submitted and tracked here. Online building permission in Madhya Pradesh is done through the ABPAS system, in which scrutiny of drawings is processed online transparently without any human intervention.

The key technical requirement: ABPAS requires drawings prepared in a specific Pre-DCR formatted file — not a standard AutoCAD .dwg. Layers for plot boundary, setback, FAR, and ground coverage must be defined in ABPAS's own format. A standard drawing file submitted by an architect unfamiliar with ABPAS is rejected automatically at the software scrutiny stage.
One critical verification step for buyers and homeowners: Plans sanctioned through the ABPAS portal carry a digital trail — verify the sanction number on the portal yourself. No portal record means the document is not genuine. This is the single most reliable way to verify that a building plan approval is real before purchasing a property or starting construction.
For how Jabalpur's portal compares nationally, see Building Plan Approval in India — Complete Process 2026. For the Bhopal ABPAS guide which runs on the same MP system, see Building Plan Approval in Bhopal 2026.

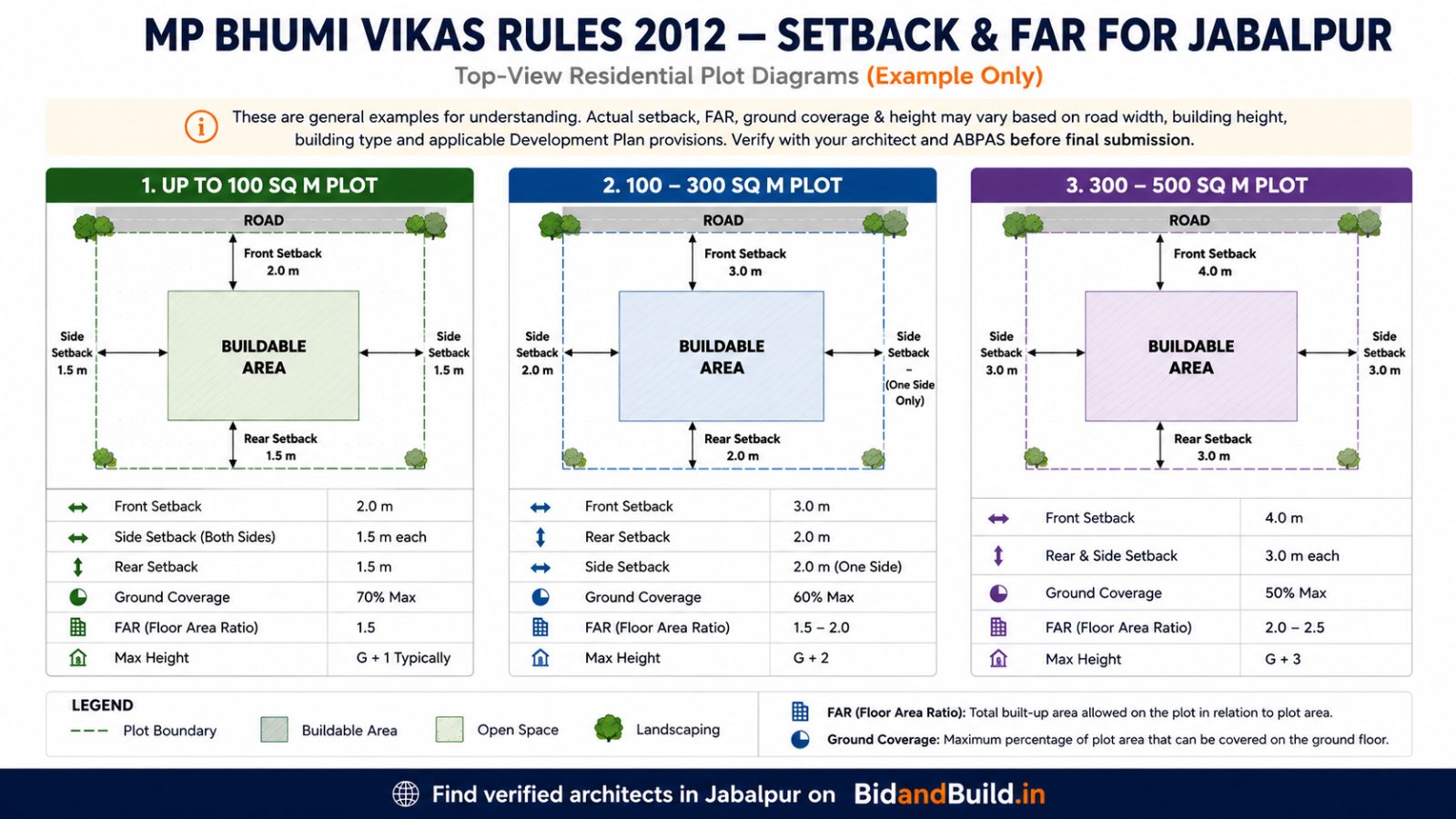

MP Bhumi Vikas Rules 2012 — Setback and FAR for Jabalpur
All setback, FAR, and height rules in Jabalpur are governed by the MP Bhumi Vikas Rules 2012. Most ABPAS rejections happen because drawings violate these rules — design within them from the first sketch.

For plots up to 100 sq m:
| Rule | Requirement |
|---|---|
| Front setback | 2 m minimum |
| Side and rear | 1.5 m |
| Ground coverage | 70% max |
| FAR | 1.5 |
| Max height | G+1 typically |
For plots 100–300 sq m:
| Rule | Requirement |
|---|---|
| Front setback | 3 m |
| Rear setback | 2 m |
| One side | 2 m |
| Ground coverage | 60% max |
| FAR | 1.5–2.0 |
| Max height | G+2 |
For plots 300–500 sq m:
| Rule | Requirement |
|---|---|
| Front setback | 4 m |
| Rear and sides | 3 m each |
| Ground coverage | 50% max |
| FAR | 2.0–2.5 |
| Max height | G+3 |
Keep a 15cm buffer beyond every minimum setback. ABPAS auto-flags exact shortfalls — a projecting step or ramp into the front setback is one of the most common rejection reasons in Jabalpur submissions.
Documents Required for JDA/JMC Approval in Jabalpur
Mandatory for all projects:
| Document | Note |
|---|---|
| Registered sale deed / allotment letter | Must match revenue records exactly — including name spelling |
| Khasra / Khatauni (revenue record) | Updated, with JDA/JMC zone clearly marked |
| COA-registered architect certificate | Only licensed COA architect can sign drawings |
| Architectural drawings (Pre-DCR format) | Floor plans, elevations, sections, site plan in ABPAS format |
| Structural drawings | Required for G+2 and above |
| Plot photographs | Front, rear, both sides |
Required in specific cases:
| Document | When Required |
|---|---|
| Cantonment Board NOC | Plots within or adjoining Cantonment boundary |
| MOEF NOC | Narmada riverside / flood zone plots |
| Fire NOC | G+3 and above or above 15m height |
| Airport NOC | Plots near Dumna Airport flight path |
| Forest department NOC | Plots adjacent to reserved forest zones |

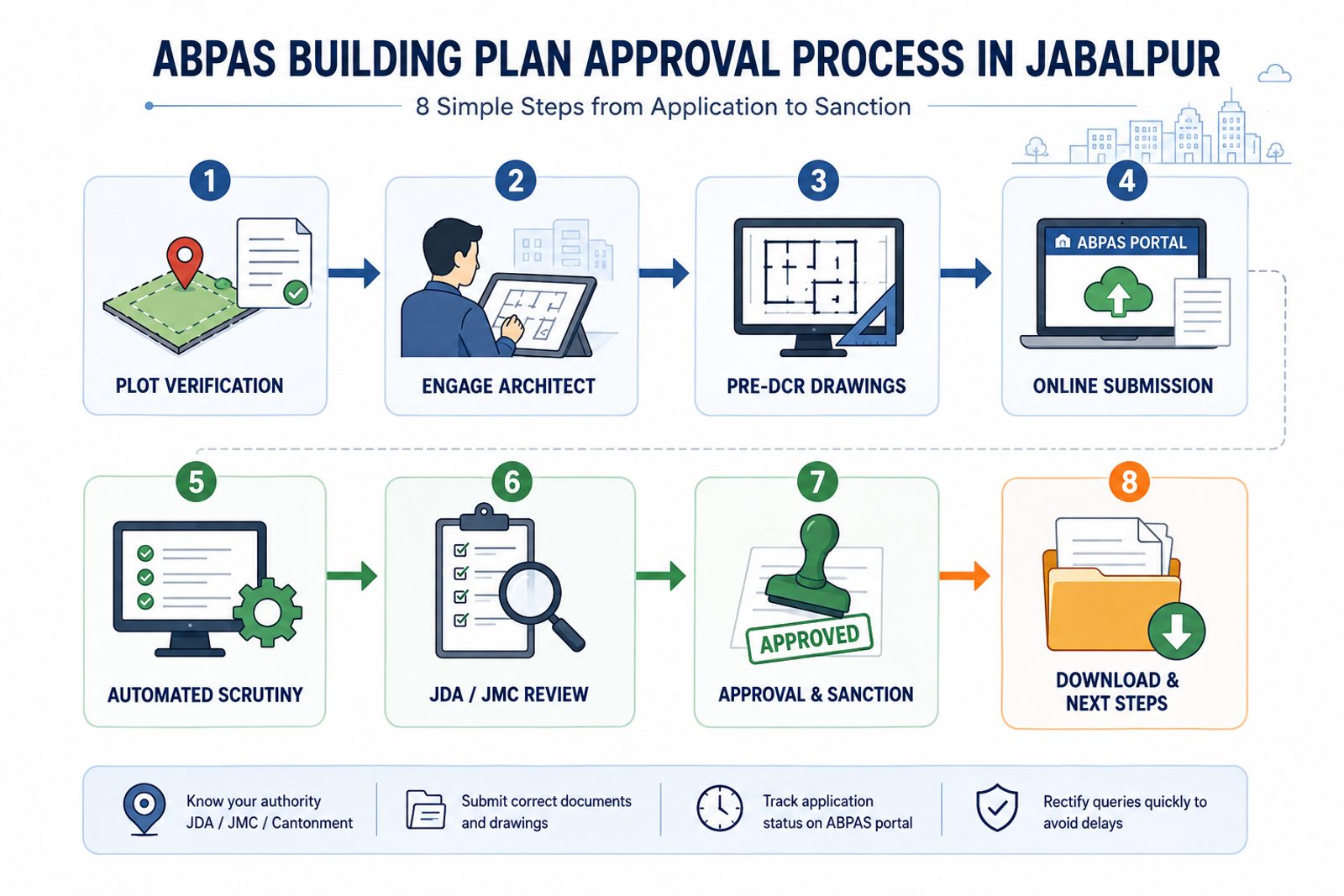

Step-by-Step ABPAS Approval Process (Jabalpur 2026)
- Confirm authority — registry document confirms JDA or JMC jurisdiction. Cantonment proximity must also be checked.
- Hire a COA-registered architect — only a licensed architect can prepare and submit ABPAS drawings.
- Plot verification on ABPAS — architect verifies your plot in the ABPAS database, confirms zone, FAR, and setback rules.
- Pre-DCR drawing preparation — ABPAS-formatted drawings with all mandatory layers. Typically 7–14 days for an experienced ABPAS user.
- Online submission — login to mptownplan.gov.in, upload all documents and drawings, pay scrutiny fee online.
- Automated software scrutiny — ABPAS checks setback, FAR, coverage, and height automatically with no human intervention at this stage.
- JDA/JMC officer review — if software scrutiny passes, officer reviews for document completeness and applicable NOCs.
- Sanction letter download — available on ABPAS portal with unique sanction number. Valid 3 years from date of issue.
Track your application: mptownplan.gov.in → Application Status → Enter your file number.

Fees for Building Plan Approval in Jabalpur (2026)
For a standard 1,000–1,500 sq ft residential home:

| Fee Component | Amount |
|---|---|
| Application + Scrutiny fee | ₹5,000–₹12,000 |
| Building permission fee | ₹15,000–₹40,000 |
| MP Labour Cess (1% of construction cost) | ₹10,000–₹25,000 |
| Structural stability certificate | ₹8,000–₹20,000 |
| Completion / Occupancy Certificate | ₹5,000–₹12,000 |
| Electricity + Water connection | ₹15,000–₹30,000 |
| Total (standard residential) | ₹40,000–₹90,000 |
The most commonly missed cost: MP Labour Cess at 1% of total construction cost, paid separately at the MP BOCW (Building and Other Construction Workers) Board — not through ABPAS. On a ₹20 lakh project, this is ₹20,000.
Quick formula:
Construction Cost (₹) × 1% = MP Labour Cess
Add ₹30,000–₹50,000 for all other JDA/JMC fees.
Example: ₹20 lakh construction × 1% = ₹20,000 Labour Cess + ₹40,000 fees = ₹60,000 total approval budget.
Fee by project size:
| Project | Approx. Total Fee |
|---|---|
| 1,000 sq ft G+0 | ₹40,000–₹60,000 |
| 1,500 sq ft G+0 | ₹50,000–₹70,000 |
| 1,500 sq ft G+1 | ₹60,000–₹80,000 |
| 2,000 sq ft G+1 | ₹70,000–₹90,000 |
Architect Fees for ABPAS Approval in Jabalpur (2026)
| Service | Fee Range |
|---|---|
| Architectural design (basic) | ₹18–₹35/sq ft |
| Full service (design + 3D + ABPAS drawings) | ₹35–₹70/sq ft |
| Structural engineering | ₹15,000–₹40,000 |
| ABPAS/JDA liaisoning | ₹12,000–₹35,000 |
| Cantonment NOC liaisoning (if required) | ₹15,000–₹30,000 additionally |
| Site supervision (monthly) | ₹10,000–₹30,000 |
For a standard 1,500 sq ft 3BHK in Vijay Nagar or Gorakhpur — total architect + structural + ABPAS fees: ₹60,000–₹1,10,000.
For Cantonment-adjacent projects — add Cantonment liaisoning fee and 30–45 days to your timeline from day one.
Approval by Locality: What to Expect
| Area | Authority | Key Note |
|---|---|---|
| Civil Lines / Napier Town | JMC | Core city — faster JMC timeline |
| Vijay Nagar / Adhartal | JDA | Standard JDA approval — most straightforward |
| Tilhari / NH44 corridor | JDA | Growing zone — confirm exact boundaries |
| Gorakhpur / Marhatal | JDA | Near JDA office — familiar with local architect pool |
| Sadar / Lines area | Cantonment Board | Cantonment NOC mandatory — adds 30–45 days |
| Gwarighat / Lamheta | JMC + check MOEF | Riverside — flood zone NOC may apply |
| Bhedaghat fringe areas | JDA | Basalt rock soil — check geological conditions |
Top 5 Rejection Reasons in Jabalpur
- Missing Cantonment NOC — submitted without it for a Cantonment-adjacent plot. Application rejected at first review, NOC obtained after submission adds months.
- ABPAS drawing format error — standard .dwg file submitted instead of Pre-DCR format. Auto-rejected by ABPAS software.
- Setback shortfall — 15cm buffer rule ignored. ABPAS flags exact shortfalls with zero tolerance.
- Revenue record mismatch — name spelling differs between registry and Khasra. Even one character difference causes rejection.
- Wrong authority — JDA vs JMC confusion for areas near the city boundary. Confirm jurisdiction from registry before submission.
After Approval: 4 Mandatory Steps
| Stage | What to Do |
|---|---|
| Before digging | File Commencement Notice on ABPAS portal |
| Foundation complete | Plinth Level Certificate — JDA/JMC engineer inspects |
| Construction complete | Completion Report filed on ABPAS |
| Final stage | Occupancy Certificate — JDA/JMC issues on inspection |
Why OC matters in Jabalpur: It is required for permanent MPPKVVCL electricity connection, water supply connection, home loan disbursement, and legal resale. Any deviation in setback, floors, or use is treated as unauthorised construction under MP rules and can attract penalty, demolition, or compounding charges from the Municipality. Properties without OC in Jabalpur are increasingly difficult to sell as buyers verify ABPAS sanction numbers directly.
5-Step Checklist Before Hiring a Jabalpur Architect
- Confirm JDA or JMC jurisdiction — from registry document. Never assume based on area name.
- Check Cantonment proximity — ask directly: "Is my plot within or adjacent to the Cantonment boundary?" before any design work.
- Verify COA registration — at coaonline.org. Ask for registration number upfront.
- Ask specifically about ABPAS experience — "How many applications have you submitted and cleared on ABPAS for JDA/JMC Jabalpur specifically?"
- Get 3 itemised quotes — architectural design, structural engineering, ABPAS liaisoning, and Cantonment NOC (if applicable) listed separately.
Full hiring guide: How to Hire an Architect, Contractor, or Interior Designer in India
Are You an Architect or Contractor in Jabalpur?
BidandBuild is the fastest way to reach homeowners actively planning projects in Jabalpur, Katni, Narsinghpur, Mandla, and across Central MP — with zero commission and a free verified profile.
Join BidandBuild as a professional — free
Read: How Architects Can Get More Clients in India 2026
Need Building Materials in Jabalpur?
Post your cement, steel, tiles, or electrical requirements on BidandBuild. Verified material suppliers in Jabalpur respond with competing quotes at zero commission.
Post material requirement free on BidandBuild
Frequently Asked Questions
What is the building plan approval process in Jabalpur?
Building plan approval in Jabalpur goes through MP's ABPAS portal at mptownplan.gov.in — JDA Jabalpur for planned and peri-urban areas, JMC for core city wards. A COA-registered architect submits Pre-DCR formatted drawings online. JDA approvals take 30–45 days, JMC takes 20–40 days. Cantonment-adjacent plots require an additional 30–45 days for Defence NOC.
How much does building plan approval cost in Jabalpur?
Total fees for a 1,000–1,500 sq ft residential home range from ₹40,000–₹90,000, including scrutiny fee, building permission fee, MP Labour Cess at 1% of construction cost, structural certificate, and occupancy certificate. Labour Cess is paid separately at the MP BOCW Board — not through ABPAS.
Who approves building plans in Jabalpur?
JDA Jabalpur (Block 7A, Marhatal, 0761-2402832) for planned sectors and peri-urban areas. JMC Jabalpur (nagarnigamjabalpur.com) for core city wards. Cantonment Board Jabalpur for plots within the military cantonment zone.
Do I need a structural engineer for approval in Jabalpur?
Structural engineer drawings are required for G+2 and above. For G+1 and below, standard architectural drawings are sufficient in most cases under MP Bhumi Vikas Rules 2012.
What is special about building approvals near Jabalpur Cantonment?
Plots within or adjoining the Jabalpur Military Cantonment boundary require a separate No Objection Certificate from the Cantonment Board administration before JDA or JMC will process an application. This adds 30–45 days to the timeline and requires separate liaisoning fees.
How do I verify a building plan approval is genuine in Jabalpur?
Verify the sanction number directly on the ABPAS portal at mptownplan.gov.in. All genuine approvals carry a traceable digital trail. Any seller who cannot provide the ABPAS sanction number is a red flag — do not proceed without verification.
What happens if I build without approval in Jabalpur?
No permanent electricity or water connection. No home loan. No legal resale without significant discount. JDA and JMC Jabalpur have the authority to issue demolition notices for unauthorised construction, and the MP High Court has upheld demolition orders in repeated rulings across the state.
What is ABPAS and how does it work?
ABPAS (Automated Building Plan Approval System) is MP's online building approval platform at mptownplan.gov.in. Drawings are scrutinised automatically by software without human intervention. Standard .dwg files are rejected — architects must submit in Pre-DCR format with specific layers for boundary, setback, FAR, and coverage.
What is Bid and Build?
Bid and Build is India's construction marketplace connecting homeowners with verified COA-registered architects, contractors, interior designers, and material suppliers — completely free for homeowners, zero commission. Learn more.
Ready to start your building approval in Jabalpur? Post your project once. Get 3 verified quotes from ABPAS-experienced architects. Free. Zero commission. No middlemen.
→ Post your project free on bidandbuild.in
Related Articles
Building Plan Approval in Bhopal 2026 — ABPAS Process
Building Plan Approval in India — Complete Step-by-Step Process 2026
How to Build a House in India — Complete Step-by-Step Guide 2026
How to Hire an Architect, Contractor, or Interior Designer in India
Why India's Construction Projects Fail — And How to Avoid It
